Under 45V, when does cheap electricity still produce expensive hydrogen?
Problem statement: This analysis begins where parity analysis ends. Even when a structural parity region exists on paper, instability in utilization can collapse it in operations. This note quantifies collapse thresholds, fragility gradients, and failure regimes under utilization-driven breakdown.
Reading mode: This note is intentionally split into two products. Product A is a rapid decision brief for go/no-go screening. Product B is a technical note and appendix set for audit-level traceability.
The companion parity note assumes stability and asks: can this work?
This note introduces instability and asks: does that region survive contact with operational reality?
Product A: Decision Brief (3-Minute Screen)
The following project configurations fail diligence under conservative assumptions and should be treated as immediate no-go unless the structure changes:
- Merchant intermittent power without utilization guarantees. Weather-driven CF is not underwritable as base-case project economics.
- Hourly matched procurement without firming. Matching windows compress operating hours and can push CF below viability thresholds.
- Modeled CF below 35%. Fixed-cost recovery dominates LCOH and parity is not observed across the modeled delivered-price range.
Board Go/No-Go Matrix (Procurement Strategy x Capacity Factor)
| Capacity factor regime | Annual matched (non-firmed) | Hourly matched (non-firmed) | Firmed hourly (with backup) |
|---|---|---|---|
| <35% | No-Go | No-Go | No-Go |
| 35-75% | Conditional at grey-high edge only; fails grey-mid/low | No-Go in modeled grid | No-Go in modeled grid |
| 75-90% | Conditional viability near nominal ~$25/MWh (grey-high only) | Mostly No-Go; edge cases approach parity near upper band | No-Go in modeled grid |
| >=90% | Viable edge case vs grey-high near nominal ~$25/MWh | Viable edge case vs grey-high near nominal ~$25/MWh | Still no parity observed in current run |
Finance overlay (WACC consistency): The parity map is benchmark-aligned at 7% real WACC, but utilization-exposed projects should be underwritten at 10-12% real in diligence. Apply a +5 to +10 percentage-point CF shift to viability thresholds under this finance stress, and treat any marginal case as No-Go unless contracts lock utilization and power cost.
Jamie R. Gomez, Ph.D. is a chemical engineer specializing in decision-grade TEA/LCA for hydrogen, SAF, and power-to-liquids pathways.
Her work has supported $36M+ in U.S. DOE-funded programs with national laboratory collaboration and benchmark-anchored validation workflows.
Core finding: With the corrected hydrogen benchmark (H2A 2024.2), parity is materially tighter than prior publication. In the refreshed grid, clean hydrogen does not clear grey-low or grey-mid parity; only limited grey-high parity remains under extreme low-price and high-utilization conditions.
Why it matters: The clean hydrogen investment thesis is often reduced to finding cheap power. This framing obscures a more fundamental constraint. Electrolyzers must operate at sufficiently high and stable utilization to amortize capital and realize credit value. Procurement strategies optimized for low nominal electricity prices frequently introduce intermittency or matching constraints that collapse realized utilization, erasing apparent cost advantages and breaking parity with grey hydrogen.
Headline thresholds: Grey reference band in the refreshed run is $1.00, $1.70, and $2.50 per kilogram. Parity vs grey-high appears only near annual matched nominal ~$25/MWh with CF >=75% and hourly matched nominal ~$25/MWh with CF >=90%. Firmed-hourly cases do not reach parity in-grid.
Method snapshot: Independent techno-economic parity modeling of electrolyzer utilization, delivered electricity price including losses and adders, and 45V credit interactions at the user gate.
Pull quote: "After correcting the benchmark scale mismatch, the practical question is no longer where grey-mid parity appears, but whether any robust parity remains outside narrow grey-high edge cases."
Framework Application: DG-PFF (Parity Fragility Framework) within the DG-TEA methodological discipline. Framework details.
Decision Summary
Decision question
Under finalized 45V rules, at what utilization and intermittency conditions does an apparent parity region collapse in real operations?
Decision owner and deadline
- Decision owner: Project developer / operating team / lender downside-case underwriter
- Decision deadline: Prior to site selection, electrolyzer sizing, and electricity procurement contracting. Once these decisions are locked, utilization outcomes and credit eligibility become costly or impossible to reverse.
Applicability
This analysis applies to U.S. clean hydrogen projects seeking 45V credits under finalized Treasury guidance. The analytical method is domain-agnostic and transferable to other policy-constrained energy systems where utilization and eligibility interact, including clean ammonia and power-to-liquids fuels.
Confidence / robustness tag
Confidence: Medium-High. Benchmarks reflect recent U.S. grey hydrogen cost ranges and commercial electrolyzer performance, and policy rules reflect Treasury guidance valid as of February 2026. Results are scenario-based and illustrate decision thresholds, not forecasts. Quantitative screening envelope: treat the utilization cliff near approximately 60% CF as a band of roughly 55-65% in the base configuration; under higher CAPEX/WACC stress, this can widen toward approximately +/-10 percentage points.
Decision context (fast read)
Under 45V, this is an operational survivability problem, not a static cost-ranking exercise. Utilization losses from intermittency, matching constraints, and procurement structure can erase parity that appears feasible in structural screening. Electricity price still matters, but it is secondary when runtime instability amplifies fixed-cost recovery.
Collapse thresholds and survivability bands
- Observed viability threshold (grey-high only): Annual matched requires roughly >=75% CF at nominal ~$25/MWh; hourly matched requires roughly >=90% CF at nominal ~$25/MWh.
- Grey-mid/low feasibility: Not observed in the current modeled domain after benchmark correction.
- Cheap-power trap (reframed): Low nominal price without very high sustained utilization remains non-viable for grey-mid parity under corrected cost structure.
- Policy-amplified cliff: Utilization shortfalls near eligibility or credit tier boundaries still amplify cost penalties and compress the already narrow feasible region.
- Screening uncertainty band: Treat threshold CF values as ranges, not points. For decision screening, use approximately +/-5 pp around reported thresholds in base assumptions and up to approximately +/-10 pp under CAPEX/WACC stress.
What fails diligence screens (early gate)
The following configurations are non-bankable under conservative assumptions. They do not “struggle” or “face challenges.” They fail.
- Merchant intermittent power without utilization guarantees. Without contracted capacity-factor floors, utilization is a weather outcome. Lenders cannot underwrite weather outcomes as base-case economics.
- Hourly-matched strategies without firming. Hourly matching compresses CF to the availability profile of the matched generation. Without storage or firming, solar-only configurations often fall below 40% CF and wind-only below 50% in many regions.
- Projects with modeled CF below 35%. These projects are structurally non-competitive across the modeled delivered-price range because capital recovery overwhelms electricity-price advantage.
Dominant sensitivities (ranked)
- Electrolyzer capacity factor (utilization)
- Fixed-cost recovery burden under reduced operating hours
- Delivered electricity price (including losses and adders)
Secondary: Electrolyzer efficiency, minor transmission losses, non-power OPEX.
Driver ranking method: Ranked by decision-flip frequency and parity-boundary area shift across the scenario grid.
Primary outputs (this note)
- Collapse threshold (where parity ceases to survive)
- Fragility gradient (how fast cost deteriorates as utilization drops)
- “Can this survive operations?”
Decision regimes
(Refreshed grid with corrected benchmark; Tier 1 credit assumption)
| Regime | Conditions | Decision posture |
|---|---|---|
| Clearly viable (limited) | Observed only for grey-high benchmark cases near nominal ~$25/MWh with sustained high CF (annual matched: >=75%; hourly matched: >=90%). | Proceed only with site-specific validation proving sustained high utilization and contractable low nominal power. |
| Conditional / transitional | Annual matching can show narrow transition-window feasibility, but robustness erodes under hourly compliance and tier haircut stress. | Treat as transitional only; re-underwrite on hourly-matching assumptions before investment decision. |
| Non-viable (dominant case) | No parity observed for grey-low ($1.00/kg) or grey-mid ($1.70/kg) benchmarks across modeled nominal price ($25-$110/MWh) and CF (30%-95%) ranges. | Do not proceed without structural changes (different benchmark, policy support, utilization regime, or delivered-power structure). |
If this screen is decision-relevant for an active investment, move directly to a scoped professional intake:
Structured intake: Professional inquiry form (organization, project stage, required scope, timeline)
Direct contact: jamie@insightquantix.com
Representative archetypes (illustrative)
The thresholds below are presented as general decision boundaries. The archetypes here are reference configurations, not project claims, to help readers map the analysis to common development contexts.
- Low-cost, intermittent power with low sustained utilization: Appears cost-competitive on nominal $/MWh but fails parity due to utilization collapse. Use threshold map to verify CF remains above viability floor.
- Moderate-cost, firm power with high utilization: Higher nominal electricity price offset by sustained capacity factor. Often clears parity where intermittent strategies fail.
- Hybrid procurement with partial firming and intermediate utilization: Mixed strategy that can recover parity if utilization remains stable across matching periods.
Decision Rules (Refreshed Parity Surface)
Clearly viable (edge case only)
- Annual matched, non-firmed: parity observed only vs grey high ($2.50/kg) near nominal ~$25/MWh with CF >=75%.
- Hourly matched, non-firmed: parity observed only vs grey high near nominal ~$25/MWh with CF >=90%.
- Firmed hourly with backup: no parity observed across modeled grid.
Conditional / transitional
- Annual-matched results can indicate transition-period feasibility but should not be treated as long-run underwriting basis post-hourly matching transition.
Non-viable (most of current domain)
- No parity observed vs grey low ($1.00/kg).
- No parity observed vs grey mid ($1.70/kg).
Risk rules (apply across scenario ensemble)
- Treat utilization as a gating variable, not a sensitivity.
- Treat electricity price as a secondary lever once utilization falls below survivability bands.
- Re-evaluate parity whenever procurement strategy, matching regime, or electrolyzer sizing materially changes.
- Underwrite at 10-12% real WACC for utilization-exposed projects; if parity holds only at 7% and fails at stress WACC, classify as non-viable until financing risk is contractually mitigated.
Cliff mechanisms captured (policy valid as of February 2026)
- Matching-driven utilization collapse (hourly vs annual matching)
- Credit value dilution under boundary haircuts
- Fixed-cost amplification under reduced operating hours
- Grey benchmark bands as reference cases
Assumptions note: Forward-looking inputs are scenario assumptions, not predictions. Grey benchmark bands reflect recent U.S. market ranges; actual grey hydrogen costs vary by region and time.
Rapid screening: Use the Decision Summary and Decision Rules to determine whether a project's power procurement and utilization profile is structurally compatible with clean hydrogen parity under 45V. Internal diligence: Pair with Appendix A parameters and stress-test utilization assumptions before committing to detailed engineering or contracting.
1) Map candidate sites: Plot candidate sites onto the electricity price x utilization domain using realistic (not optimistic) CF estimates.
2) Identify decision regime: Determine whether the site falls into clearly viable, conditional, or non-viable territory.
3) Stress-test utilization: Apply curtailment, matching, and intermittency scenarios to test whether CF remains above viability threshold.
4) Apply credit haircuts: Re-evaluate parity under credit boundary haircuts if lifecycle emissions sit near tier thresholds.
5) Gate the decision: Proceed only if parity remains robust under stress scenarios; otherwise, re-scope procurement or abandon.
For project-specific professional deliverables, inquiries are handled through a dedicated intake path. Engagements are fixed-scope and deliverable-based.
Structured intake: Professional inquiry form (organization, project stage, scope needed, and timeline).
Direct email: jamie@insightquantix.com
Related notes: 45V Hydrogen Cost Parity vs Grey | All Insights
Product B: Technical Note (Audit Trail)
The sections below provide full derivation logic, parameter traceability, stress conditions, and reproducibility details that support the decision brief above.
1. Decision Context
This analysis begins where parity analysis ends. The economics of clean hydrogen under 45V are often summarized as a race to the lowest electricity price, but this framing obscures the dominant failure mechanism: electrolyzers must operate at sufficiently high and stable utilization to amortize capital costs and fully realize credit value.
Procurement strategies that prioritize low nominal electricity prices frequently introduce intermittency, curtailment, or matching constraints that suppress realized utilization. Under 45V, these utilization losses are amplified by eligibility and credit-tier rules, transforming what appears to be a continuous sensitivity into a discontinuous feasibility problem.
The failure chain is specific. Matching constraints reduce available operating hours. Reduced operating hours lower effective capacity factor. Lower capacity factor increases capital recovery per kilogram. Once capital recovery dominates the cost stack, electricity price savings no longer affect parity. The project fails not because power is expensive, but because the electrolyzer does not run enough to amortize itself.
Premise: Low electricity prices typically require intermittent renewable procurement or constrained matching windows.
Implication: Intermittency and matching constraints reduce realized electrolyzer operating hours, lowering effective capacity factor.
Outcome: Lower capacity factor increases levelized capital recovery per kilogram of hydrogen, overwhelming any electricity cost savings.
Conclusion: Price alone is insufficient. Without reliable utilization above the viability threshold, cheap power produces expensive hydrogen.
The relevant decision is not whether cheap power exists, but whether it can be converted into hydrogen production economics that beat grey at the user gate, while remaining inside a viable credit tier. This note quantifies where that conversion fails.
A custom engagement extends this public note by adding site-specific dispatch modeling, regional grid and deliverability overlays, and contract-structure review (PPA, firming, curtailment, and REC design) for a defined project boundary. It also stress-tests financing and credit-haircut interactions against your exact procurement stack, rather than benchmark screening ranges.
Where the companion parity analysis identifies the feasible regions for clean hydrogen cost competitiveness, this note examines why many projects fail to remain within them.
1.1 Policy Context (Why Matching Rules Matter)
45V eligibility hinges on three constraints that directly amplify utilization risk:
Additionality - Electricity must come from generation capacity that would not have been built absent the hydrogen project. This limits access to existing low-cost baseload and pushes projects toward new-build renewables with inherently variable output.
Deliverability - The clean electricity must be deliverable to the electrolyzer location within the same region or balancing authority. Congestion, transmission constraints, and locational pricing differences can force projects to curtail or accept higher-cost power to maintain compliance.
Temporal matching - Under hourly matching, the electrolyzer can only run when matched clean generation is producing. This directly constrains capacity factor for intermittent-coupled projects and introduces weather-driven utilization volatility that annual matching would otherwise smooth.
These three pillars interact to create a utilization penalty that is not visible in nominal PPA pricing. A project with access to low-cost wind at $25/MWh may realize only 35-45% CF under hourly matching, pushing effective hydrogen cost above grey parity despite the apparent electricity price advantage.
The 45V framework transforms cheap intermittent power from an advantage into a potential liability. Projects must evaluate not just electricity price, but the utilization regime implied by their compliance pathway.
1.2 TEA-LCA linkage under hourly matching
For 45V diligence, parity and emissions must be read together. The lifecycle intensity relevant to tier eligibility is production-weighted over matched operating hours:
CI_H2 = (sum_t(E_t * CI_elec,t) + upstream_t) / sum_t(H2_t)
When hourly matching suppresses operating hours, economics degrade through lower CF; separately, emissions outcomes depend on the carbon intensity of the matched electricity in the hours that do run. This note treats credit tier as a scenario input; project-level diligence should pair this TEA surface with an hour-resolved LCA check before underwriting Tier 1 value.
2. Parity Claim
The parity claim tested here is that low nominal electricity prices can deliver clean hydrogen cost parity with grey hydrogen under 45V.
3. Parity Metric
Parity in this note is defined at the boundary where delivered clean hydrogen cost equals delivered grey hydrogen cost for each benchmark band, conditional on procurement strategy and sustained utilization.
Traceable model form used in this note
For each scenario point, the model computes net LCOH as:
LCOH_net = (F_fixed / Q_annual) + C_nonpower + (P_delivered * e_kWhkg) - Credit_45V
Where:
F_fixed= annualized fixed-cost term (annualized CAPEX; fixed OPEX tracked separately inC_nonpower)Q_annual = Q_nameplate * CFC_nonpower= non-electric OPEX per kgP_delivered= delivered electricity price after adders and lossese_kWhkg= electrolyzer electricity intensity (kWh/kg H2)
This is the exact algebra implemented in the parity engine (iq_app/core/tea_core/h2_parity.py) that generated the figures in this note.
One-page parameter transparency (base run)
| Parameter | Value used in this note | Source / traceability |
|---|---|---|
| Benchmark dataset | H2A PEM electrolysis 2024 reference (internal 2024.2 normalized release) |
iq_app/data/benchmarks/hydrogen/H2A_PEM_electrolysis_2024.json + IQ normalization ledger |
| Reference annual hydrogen output | 54.75 million kg/yr at 97% CF | H2A benchmark |
| Implied nameplate output | 56.44 million kg/yr | Derived: 54.75 / 0.97 |
| CAPEX basis (reference block) | $300 million total benchmark CAPEX | H2A benchmark CAPEX block |
| Annualized CAPEX at 7% real, 30y | $24.18 million/yr | CRF transform in parity engine |
| Non-electric OPEX | $0.548/kg H2 | Derived from benchmark total OPEX minus electricity OPEX |
| Electricity price sweep | $25-$110/MWh nominal, translated to delivered with strategy adders/losses | Scenario grid in note + Appendix A |
| Electrolyzer efficiency profiles | PEM 55 kWh/kg; alkaline 50 kWh/kg (screening profile) | Appendix assumptions |
| Stack life / replacement convention | 80,000 operating hours; replacement-cost treatment in OPEX sensitivity block | H2A notes + IQ degradation assumptions |
| Financial base case | 7% real discount rate; 30-year life | Appendix A |
| Financial stress case | 10% and 12% real discount-rate stress | Section 9 (added) |
The PEM assumption of 55 kWh/kg is intentionally conservative relative to best-in-class commercial claims (often ~47-52 kWh/kg on LHV basis). This pushes the parity boundary toward stricter conditions and should be interpreted as a prudence bias, not an optimistic case.
Sensitivity derivation (auditable)
From the equation above:
dLCOH / dP_MWh ~= e_kWhkg / 1000-> approximately $0.050-$0.055 per kg per $/MWh for 50-55 kWh/kg.dLCOH / dCF_pp ~= -(F_fixed * 100) / (Q_nameplate * CF^2).
Using the fixed-cost envelope implied by the CAPEX/WACC cases in this note, the CF derivative in the 40-60% region is approximately $0.03-$0.06 per kg per percentage-point CF, matching the reported cliff behavior order-of-magnitude.
Interpretation: local price and CF derivatives are both material, but realized project deviations are usually multi-point CF shifts (not single-point), which is why utilization remains the decision-flip driver in diligence.
H2A 2024.2 correction (what changed)
The prior publication mixed benchmark components that were not fully normalized to the same throughput basis. The 2024.2 correction reconciles CAPEX, OPEX, output denominator, and utilization basis onto one internally consistent reference scale before scenario sweeps are run.
This matters because utilization-risk conclusions are denominator-sensitive: when fixed-cost terms and output scale are consistently aligned, apparent parity area contracts materially. That is why the refreshed runs remove grey-mid parity in the modeled grid and leave only narrow grey-high edge cases.
4. Fragility Metric
Driver 1 - Electrolyzer Utilization (Capacity Factor)
Utilization governs fixed cost recovery and effective credit realization. Below a minimum capacity factor, even deeply discounted electricity cannot sustain parity with grey hydrogen.
Model results show no grey-mid/low parity across the current modeled range after benchmark correction. Utilization remains the gating variable, but high utilization alone is insufficient without very low nominal electricity and favorable policy realization.
Driver 2 - Electricity Procurement Strategy
Matching regime and firming choices determine realized utilization, not just nominal price. Annual matching preserves higher utilization than hourly matching for intermittent supply; firming adds cost but stabilizes CF.
Procurement strategies that reduce nominal electricity cost but simultaneously reduce utilization can result in net higher LCOH. The cheap power headline does not survive utilization-adjusted accounting.
Driver 3 - Capital Recovery Under Reduced Hours
Lower utilization increases per-kg capital burden, compounding electricity cost penalties. This effect is nonlinear: small utilization losses at low CF have outsized cost impacts.
At approximately 50 percent CF, capital contribution to LCOH is materially higher than at 60 percent CF. This differential can exceed the cost savings from further electricity price reductions.
Utilization vs. price elasticity
Both levers are first-order and the model should show that explicitly.
- Electricity-price derivative: approximately $0.050-$0.055/kg per $/MWh (from 50-55 kWh/kg intensity).
- Utilization derivative (40-60% CF zone): approximately $0.03-$0.06/kg per percentage-point CF, depending on fixed-cost burden and financing assumptions.
The practical cliff behavior comes from scale of movement, not just local derivative. Procurement choices can shift realized CF by 5-20 percentage points, while negotiated power improvements are often single-digit $/MWh. That asymmetry is what collapses parity in real projects.
Screen decisions using combined shocks, not one-variable sensitivity. A 5 pp CF loss can erase the benefit of several $/MWh power-price improvement under typical 45V procurement structures.
Sensitivity priority recap (for quick scan): 1) Electrolyzer utilization (capacity factor), 2) Delivered electricity price, 3) Capital recovery under reduced hours.

Figure 5 - Driver Sensitivity Tornado
LCOH impact per unit change in each input variable
Figure 5: Tornado bars show one-step perturbations around the baseline point. Delivered electricity has strong per-unit slope, while utilization remains the dominant decision-flip variable because realistic CF deviations are larger and interact nonlinearly with fixed-cost recovery near the cliff region.
Utilization is the dominant fragility variable in project screening. Local one-step sensitivities alone are insufficient; what matters is that plausible utilization shocks are large, nonlinear near the cliff, and often coupled to procurement constraints. Secondary variables remain lower-priority for decision flips.
Decision relevance: Use the tornado ranking to prioritize diligence effort. Spend the most time validating utilization assumptions; spend less time refining secondary cost inputs that do not affect the viability decision.
5. Viability Region
The figures below are presented as decision thresholds and feasibility bands. Each figure is paired with the decision it informs.
Visuals included (checklist)

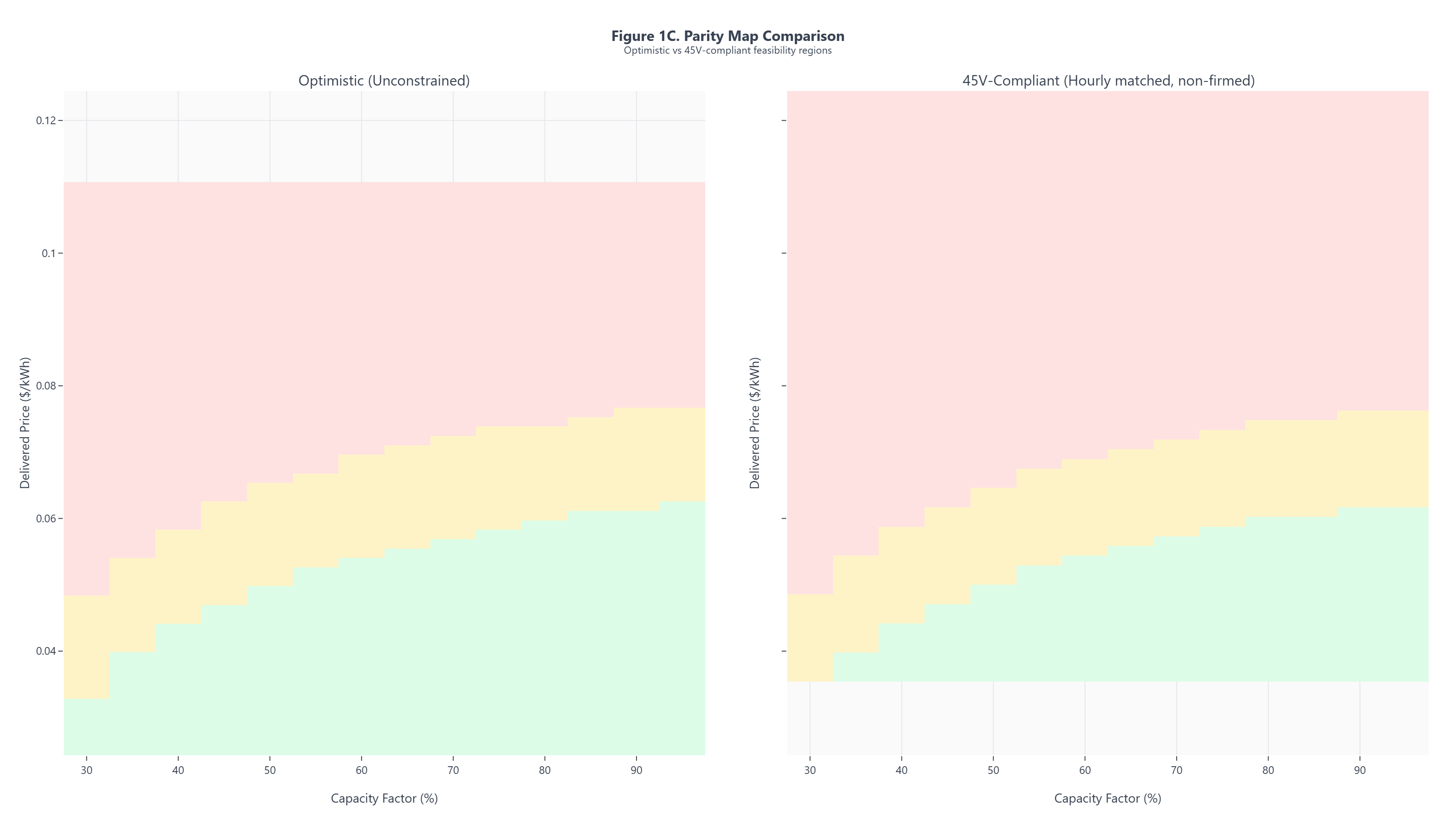

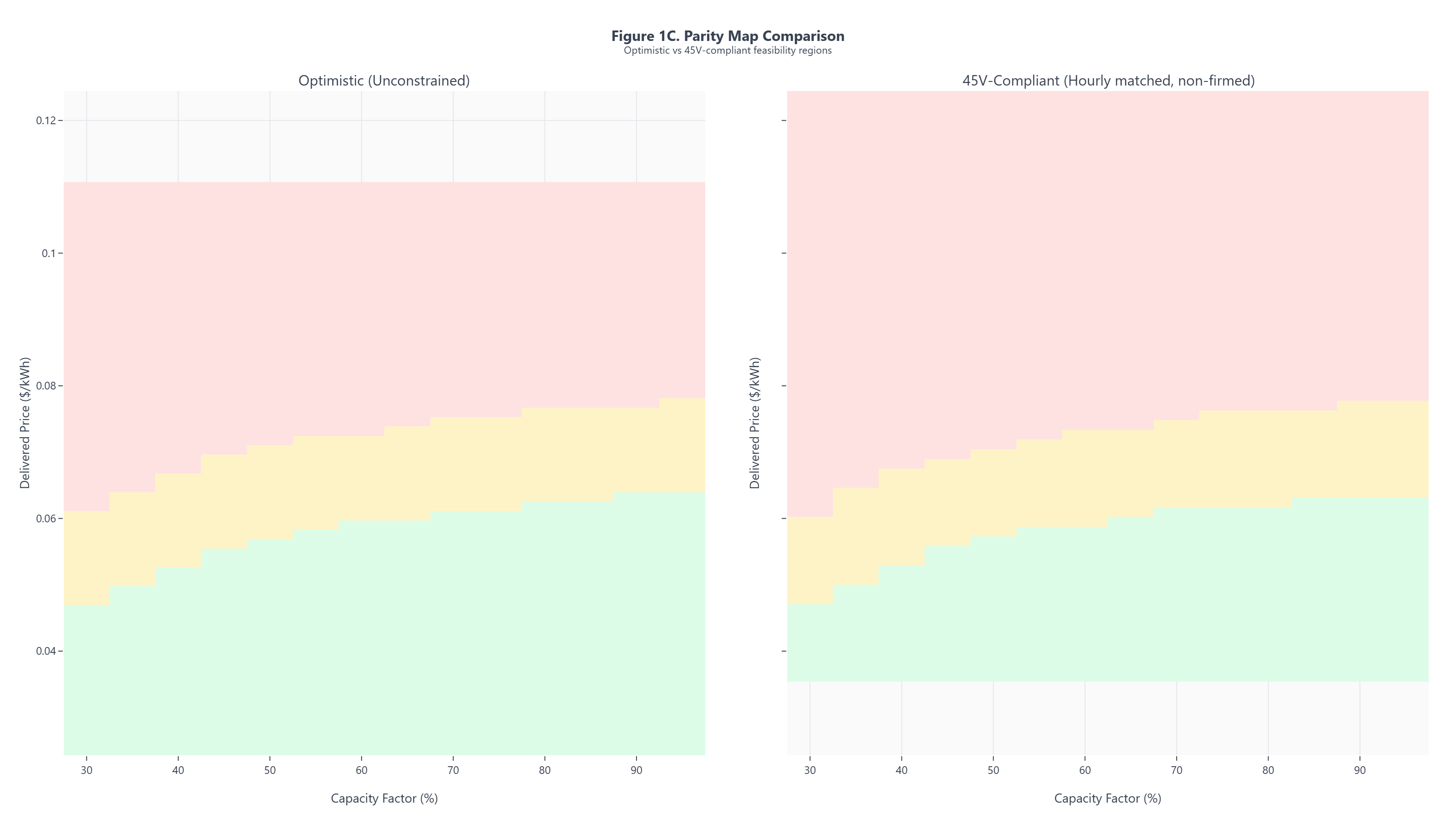

- Parity map comparison (Figure 1)

- LCOH risk surface (Figure 1B)

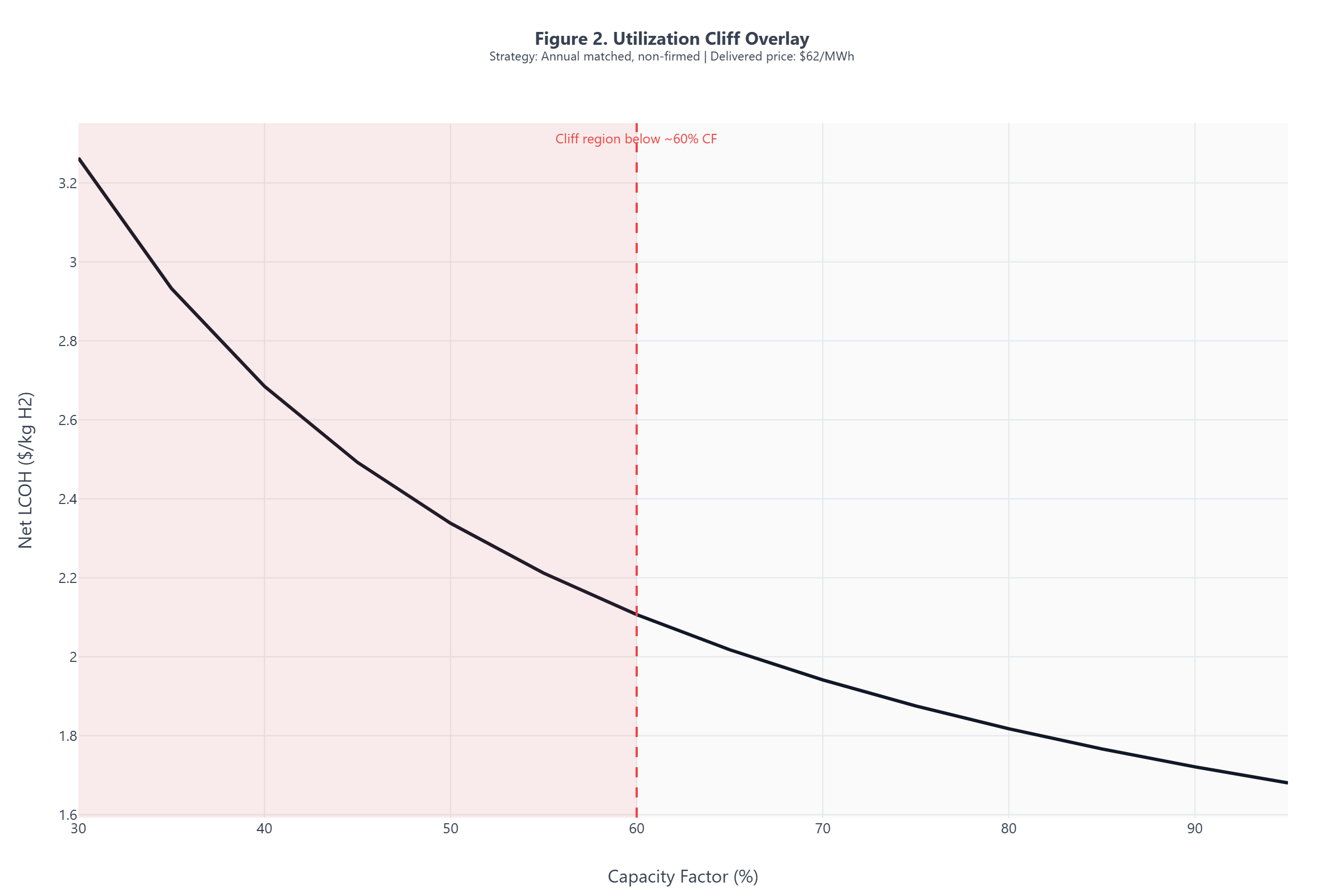

- Utilization cliff overlay (Figure 2)
- Effective electricity price breakdown (Figure 3)
- LCOH vs capacity factor curve (Figure 4)
- Decision regime table (Decision Summary)
- Driver sensitivity tornado (Figure 5)
Figure 1 - Parity Map Comparison
Contrast optimistic (unconstrained) vs 45V-compliant feasibility regions in delivered price x CF space.
Figure 1: Parity Map Comparison. Contrast optimistic (unconstrained) vs 45V-compliant feasibility regions in delivered price x CF space.
The comparison isolates the realism gap directly: optimistic assumptions overstate feasible parity area, while 45V-compliant constraints contract the viable region toward higher utilization and lower delivered price combinations.
Decision relevance: Use this side-by-side map to stress-test model assumptions and avoid screening decisions based on unconstrained parity regions that do not survive 45V-compliant operation.
Figure 1B - LCOH Risk Surface
Delivered hydrogen cost as a function of electricity price and capacity factor
Figure 1B: The LCOH surface reveals the full cost landscape across the price-utilization domain. The steep wall below 50-60 percent CF confirms that cost behavior is cliff-like, not gradual. The flat region above 70 percent CF and below $40/MWh defines the structurally viable zone.
The surface makes visible what the threshold map implies: there is no smooth path from low utilization to parity. The cost landscape has a wall, not a slope. Projects on the wrong side of the wall cannot cost-optimize their way to viability through electricity price reductions alone.
Decision relevance: Use the surface plot to visualize the magnitude of cost penalties at different operating points. The vertical axis quantifies what the parity map shows as boundaries: how much cost increases when a project drifts outside the feasibility region.
Figure 2 - Utilization Cliff Overlay
Where small CF losses produce large cost jumps
Figure 2: Cost sensitivity to utilization is nonlinear. Below approximately 60 percent CF, small utilization losses produce disproportionate cost jumps that flip the decision from viable to non-viable.
Cost sensitivity to utilization is highly nonlinear below approximately 60 percent CF. Projects operating near this threshold carry asymmetric downside risk: small utilization losses flip the decision from viable to non-viable.
Note: Cliff behavior is amplified when credit-tier boundaries interact with utilization thresholds.
Decision relevance: Avoid sizing or procurement strategies that place expected utilization near the cliff region without substantial margin.
Figure 3 - Effective Electricity Price by Procurement Strategy
Includes adders, losses, and utilization effects
Figure 3: Nominal PPA price is not the decision variable. Once matching, firming, and utilization penalties are included, some higher-priced firm strategies deliver lower hydrogen cost than cheaper intermittent strategies.
Nominal PPA price is not the decision variable. Once utilization effects are included, some "expensive" firm power strategies deliver lower hydrogen cost than "cheap" intermittent strategies with utilization collapse.
Note: Effective price reflects nominal price plus modeled adders and loss penalties, adjusted for utilization impact on capital recovery.
Decision relevance: Evaluate procurement options on effective hydrogen cost, not headline electricity price.
Figure 4 - LCOH vs Capacity Factor
Capital recovery dominance at low utilization
Figure 4: Capital recovery accelerates below approximately 60 percent CF and becomes severe below approximately 50 percent CF. In this region, parity erodes rapidly for mid/high benchmark bands even when nominal electricity prices appear competitive.
LCOH rises steeply below approximately 50 percent CF as capital recovery dominates the cost stack. A project at approximately 60 percent CF pays a capital penalty that cannot be offset by marginal electricity cost reductions.
Decision relevance: Use this curve to judge how far utilization can fall before parity breaks at each electricity price point.
6. Decision Implications
For the companion threshold-first view, see Hydrogen: 45V Cost Parity vs Grey. For additional applications, browse all Insight notes.
Siting: Favor locations where utilization can be sustained at or above the viability threshold, not just where cheap power is advertised. Grid stability, curtailment history, and matching feasibility matter more than headline PPA price.
Procurement: Reliability and firming can dominate nominal price reductions. A procurement strategy that sacrifices utilization for low $/MWh may produce higher $/kg H2.
Design: Electrolyzer sizing should reflect realistic utilization based on procurement structure, not nameplate ambition or best-case availability assumptions.
Risk posture: Projects operating near utilization thresholds carry asymmetric downside risk. Small utilization losses near the cliff produce disproportionate cost impacts; margin is essential.
Utilization should be weighted above electricity price in procurement and siting decisions when any of the following conditions apply:
1. The grid region has a high intermittency index (renewable penetration above 30 percent with limited dispatchable backup).
2. The PPA or procurement structure lacks firming capacity or minimum energy delivery guarantees.
3. The project's base-case CF falls below 60 percent, placing it in the nonlinear cost sensitivity zone.
4. Investors or lenders require downside protection against utilization variance exceeding 10 percentage points from the base case.
5. The applicable matching regime is hourly (post-2028) and the primary electricity source is a single intermittent resource.
If two or more conditions apply, the project should be evaluated on utilization-adjusted LCOH rather than nominal electricity cost. If three or more apply, utilization risk is the dominant feasibility constraint.
Project finance interactions
Utilization risk does not stay inside the cost model. It propagates into financing terms, contract structure, and risk allocation.
Cost of capital. Lenders and equity investors price utilization uncertainty into the weighted average cost of capital. Projects with uncontracted or weather-dependent CF face higher discount rates, which further increase levelized capital recovery and tighten the parity window. A project that models 8 percent WACC but faces 10-12 percent due to utilization risk may lose 15-25 percent of its apparent cost margin before operations begin.
PPA design. Procurement contracts that prioritize low headline price without CF guarantees transfer utilization risk from the power seller to the hydrogen project. Effective PPA structures for hydrogen should include minimum annual energy delivery obligations, curtailment compensation mechanisms, and utilization floor commitments. Without these, the PPA price is not the delivered cost.
Contractual risk mitigants. The following contract features directly address utilization risk:
- Capacity factor floors in offtake or PPA agreements that guarantee minimum operating hours
- Take-or-pay structures with the power supplier that align incentives around delivery, not just availability
- Firming obligations that require the electricity provider to backstop intermittency gaps
- Utilization-indexed pricing in hydrogen offtake agreements that adjust delivery commitments to realized CF
Projects that lack these structural protections carry utilization risk as unhedged exposure. Diligence should verify that contract terms match the utilization assumptions in the cost model.
7. Scope & Boundaries
Boundary statements (scope gate):
- Geography/market: United States; 45V-eligible clean hydrogen markets.
- System boundary: Delivered-to-user gate cost parity (not plant fence, not policy-adjusted averages).
- Time boundary: Commercial year 2026 with 45V policy vintage valid as of February 2026.
- Analytical scope (excluded disciplines): No legal interpretation, certification advice, detailed process engineering/design, permitting, or grid-dispatch modeling.
- Baseline definition: Grey hydrogen comparators defined by low/mid/high delivered cost benchmarks (see Appendix A). Grey low (~$1.00/kg), mid (~$1.70/kg), high (~$2.50/kg).
7.1 Key modeling assumptions
| Parameter | Base Assumption | Variation Tested |
|---|---|---|
| Delivered electricity price | Baseline effective ~$67/MWh (from $55/MWh nominal plus strategy adders/losses) | Nominal sweep: $25-$110/MWh; effective price translated per strategy |
| Capacity factor | 50-80% (strategy-dependent) | Range: 30-95% |
| Energy storage | Not included in base case | Firmed renewable scenario includes round-trip losses |
| Firming contracts | Modeled as procurement scenario, not endogenous | Firm power scenario assumes contracted CF at higher $/MWh |
| Grid region | Region-agnostic base case | ERCOT, CAISO, PJM illustrative overlays (Section 6.2) |
| Grey hydrogen benchmark | $1.70/kg (mid case) | $1.00/kg (low), $2.50/kg (high) |
| 45V credit | $3.00/kg Tier 1 | Credit haircuts modeled at tier boundaries |
| Discount rate | 7% real | Not varied (project finance baseline) |
Storage and firming are treated as procurement strategy features that affect both delivered electricity cost and realized utilization, not as separate cost line items. See Appendix A for full parameter specifications.
Interpretation guardrails: Forward-looking inputs are scenario assumptions, not predictions. This brief is an economic parity analysis; it is not legal advice, not a project certification, and not a forward price forecast.
8. Limitations & Critiques
-
Utilization modeled as scenario-driven, not dispatch-optimized. The analysis treats capacity factor as an input scenario rather than an endogenously optimized dispatch outcome. Real projects may have more or less utilization flexibility than modeled.
-
No endogenous electricity price feedback. Electricity prices are treated as exogenous inputs. Large-scale hydrogen deployment could affect regional electricity prices, which is not captured.
-
Credit rules applied mechanically, not legally interpreted. 45V eligibility and tier boundaries are modeled based on published Treasury guidance but do not constitute legal interpretation.
-
Grey benchmark uncertainty. Grey hydrogen costs vary by region, time, and natural gas price. The low/mid/high bands are reference cases, not predictions.
-
Uncertainty treatment is screening-level, not probabilistic. This note now reports threshold envelopes and stress cases, but does not run a full Monte Carlo confidence distribution for cliff location.
Response / Mitigations. Results are intended to bound feasibility and inform early-stage decisions, not replace project-specific diligence. Stress-test utilization assumptions and grey benchmarks for site-specific contexts.
9. Stress Scenarios (Beyond Base Case)
The base-case analysis holds several inputs constant that may shift materially in practice. Projects should stress-test parity under the following scenarios:
Discount-rate stress (finance realism) - Base maps use 7% real to stay benchmark-aligned, but financing for utilization-exposed projects can clear at 10-12% real. Holding all else constant, the CAPEX carrying term increases as follows:
| WACC (real) | Delta LCOH vs 7% at 75% CF ($/kg) | Equivalent electricity-price shift ($/MWh) |
|---|---|---|
| 10% | +0.18 | +3.3 |
| 12% | +0.31 | +5.6 |
At lower CF (for example 50-60%), these uplifts are larger. This is why utilization risk and financing risk should be stress-tested together, not sequentially.
Grey benchmark volatility - The $1.70/kg mid-case assumes stable natural gas prices around $3-4/MMBtu. At $6/MMBtu (winter spike or sustained tightness), grey hydrogen rises to $2.00-2.50/kg, expanding the clean parity window. At $2/MMBtu (oversupply), grey falls to $1.00-1.20/kg, collapsing it. Forward gas curves and regional basis differentials should inform benchmark stress tests.
REC/EAC pricing risk - Clean energy attribute certificates may trade at premiums that increase effective delivered electricity cost beyond nominal PPA + adders. If hourly-matched RECs command $5-10/MWh premiums in tight markets, effective electricity cost rises accordingly.
Congestion and curtailment - Grid congestion in renewable-heavy regions (ERCOT West, CAISO shoulder hours) can force negative pricing or curtailment. While negative prices reduce nominal cost, curtailment directly reduces utilization, potentially more than offsetting the price benefit.
Interconnection-driven CF risk - Projects dependent on new generation may face interconnection delays, reducing expected utilization in early operating years. A 12-24 month delay in co-located solar/wind COD compresses the economic window for credit capture.
Re-run parity thresholds under: (1) grey benchmark at $1.00 and $2.50/kg, (2) REC adders of $5-10/MWh, (3) utilization reduced 10-15 percentage points from base case. If parity survives all three, the project has structural margin.
10. Regional Mapping (Illustrative)
Utilization risk varies materially by ISO/RTO due to differences in renewable penetration, congestion patterns, and matching feasibility:
ERCOT - High solar/wind penetration creates frequent negative pricing windows but also curtailment risk. West Texas projects face transmission constraints that can suppress realized CF despite abundant renewable resource. Hourly matching feasibility is high but utilization may be weather-limited to 40-55% for solar-only configurations.
CAISO - Duck curve dynamics create midday oversupply and evening ramps. Storage-backed firming is increasingly necessary to maintain utilization through evening hours. Projects without firming may see CF compressed to 35-45% under hourly matching despite access to low-cost midday solar.
PJM - Lower renewable penetration means less negative pricing but also less access to cheap clean power. Projects may need to rely on grid power with higher carbon intensity, pushing toward credit-tier boundaries. Firm nuclear-backed configurations may achieve higher CF (70-85%) but at higher delivered electricity cost.
| Region | Typical CF Range (Hourly Matched) | Primary Utilization Risk | Firming Requirement |
|---|---|---|---|
| ERCOT | 40-55% | Curtailment, transmission | Moderate |
| CAISO | 35-45% | Duck curve, evening ramp | High |
| PJM | 50-65% | Limited cheap clean supply | Low-Moderate |
Regional estimates are illustrative and depend on specific project configuration, interconnection point, and procurement structure.
11. Methods & Traceability (Analytical Lens)
This note applies a techno-economic parity lens using representative model runs from the Insight Quantix analysis engine. Key features of the lens:
- Comparison at the user gate (not plant fence, not policy-adjusted averages)
- Explicit modeling of:
- Electrolyzer utilization (capacity factor) as primary driver
- Delivered electricity price including adders and losses
- Capital recovery amplification under reduced operating hours
- 45V credit value under tier proximity
- Grey hydrogen modeled as a delivered cost benchmark, not a theoretical SMR minimum
- Scenario vs sensitivity treatment: Procurement strategy and grey benchmark are discrete scenarios; electricity price and capacity factor are sensitivities within each scenario.
Results reflect parametric sweeps across the stated ranges, filtered to illustrate utilization-driven parity boundaries and cliff behaviors. Results are illustrative of economic boundaries, not exhaustive optimization.
12. Appendix A: Modeling Parameters
Procurement Strategy Configurations
| Strategy | Adders ($/kWh) | Loss Fraction | Utilization Impact | Basis |
|---|---|---|---|---|
| Intermittent, annual matched | $0.005 | 3% | CF reduced by matching constraints | PPA shaping + scheduling |
| Intermittent, hourly matched | $0.010 | 3% | CF further reduced by hourly compliance | Intra-hour balancing |
| Firm power (grid or firmed renewable) | $0.020 | 5% | CF sustained at contracted level | Firming + round-trip losses |
Adders reflect incremental procurement costs beyond nominal PPA price. Loss fractions represent transmission, conversion, and utilization inefficiencies.
Scenario vs Sensitivity Classification
| Input group | Treatment | Notes |
|---|---|---|
| Procurement strategy | Scenario | Discrete regimes (intermittent/firm/hybrid) |
| Electrolyzer type | Scenario | PEM vs alkaline |
| Grey benchmark band | Scenario (reference case) | Low/mid/high delivered cost cases |
| Electricity price | Sensitivity | Continuous sweep within each scenario |
| Capacity factor | Sensitivity | Continuous sweep within each scenario |
Grey Hydrogen Benchmarks (delivered cost)
| Benchmark | Cost ($/kg H2) | Description |
|---|---|---|
| Low | $1.00 | Low-cost SMR with ~$3.00/MMBtu natural gas, no carbon capture (U.S. Gulf Coast baseline) |
| Mid | $1.70 | U.S. industrial average delivered cost, 2024-2025 |
| High | $2.50 | Merchant delivered, non-captive, or high-natural-gas-price regions |
Sources: DOE Hydrogen Program Records, IEA Global Hydrogen Review. Grey benchmarks are reference cases, not forecasts; treated as scenario variants.
Analysis Engine Configuration
| Parameter | Value |
|---|---|
| Base Credit (Tier 1) | $3.00/kg H2 |
| Electricity price range | $0.025-$0.110/kWh (nominal, pre-adders) |
| Capacity factor range | 30%-95% |
| Electrolyzer configurations | PEM (55 kWh/kg) and alkaline (50 kWh/kg) |
| Reference CAPEX block | $300 million benchmark CAPEX (H2A reference block) |
| Annualized CAPEX at base WACC | $24.18 million/yr (7% real, 30y) |
| Non-electric OPEX | $0.548/kg |
| Stack replacement convention | 80,000 operating hours; replacement treated in OPEX stress assumptions |
| Economic framework | ASTM E3200-compliant TEA |
| Discount rate | 7% real base case; 10% and 12% stress cases |
| Project lifetime | 30 years |
All analyses conform to benchmark-anchored validation protocols as described in Insight Quantix TEA-LCA Engine documentation.
13. Appendix B: Policy Compliance Mapping
13.1 45V Strategy-to-Constraint Matrix
| Procurement Strategy | Additionality | Deliverability | Temporal Matching | CF | Credit Risk |
|---|---|---|---|---|---|
| Co-located solar (new build) | Satisfied | On-site | Hourly: limited to solar hours | 25-40% | Low |
| Co-located wind (new build) | Satisfied | On-site | Hourly: limited to wind availability | 35-50% | Low |
| Solar + wind hybrid (new build) | Satisfied | On-site | Hourly: complementary profiles | 45-60% | Low |
| PPA with hourly RECs | Depends on vintage | Same region | Hourly: REC timestamp must match | 40-55% | Moderate |
| PPA with annual matching | Depends on vintage | Same region | Annual: higher CF achievable | 60-80% | Higher (post-2027 phase-out) |
| Firmed renewable (storage-backed) | Satisfied | Satisfied | Hourly: storage enables load-following | 70-90% | Low |
| Grid power (low-CI region) | Not satisfied | N/A | N/A | 85-95% | High (may fail Tier 1) |
13.2 Policy Parameter Sensitivity
Parity thresholds in this analysis assume current 45V rules. Key policy parameters that would shift thresholds if changed:
| Policy Parameter | Current Assumption | If Relaxed | If Tightened |
|---|---|---|---|
| Temporal matching | Hourly (post-2028) | Higher achievable CF, expanded parity band | N/A |
| Additionality window | 36-month lookback | More existing capacity eligible | Narrower eligible supply |
| Deliverability definition | Same region/BA | Cross-regional RECs allowed | Stricter LMP-based test |
| Tier 1 threshold | <0.45 kg CO2e/kg H2 | Higher allowed intensity | Narrower pathway |
Policy rules valid as of February 2026. Treasury guidance updates may materially alter thresholds.
14. Citation Readiness & Reproducibility
-
Publication date & version: March 2026 v1.10 - Canonical URL: https://insightquantix.com/insights/45v-utilization-risk/
- Inputs table: Appendix A (benchmarks + author assumptions labeled; scenario vs sensitivity classified)
- Reproducibility note: Parity boundaries are most sensitive to sustained utilization and procurement regime; changes to these inputs will shift decision regions. Conclusions flip primarily with CF assumptions.
- Disclosure: Insight Quantix derived all analytical conclusions independently; references provide context only.
- v1.1 literature update (selected sources): Applied Energy hydrogen TEA evidence on utilization and dispatch realism (Park et al., 2023; Superchi et al., 2023; Villarreal Vives et al., 2023; Ajanovic et al., 2024; Rezaei et al., 2024a; Rezaei et al., 2024b); 45V implementation context (U.S. Treasury final rules, IRS 2025-13 bulletin, DOE 45V resources); market and regional context (BNEF 2024 outlook, BNEF 2023 LCOH update, European Hydrogen Bank).
- Policy validity: 45V rule interpretation valid as of February 2026 (updated through 2026-02-08 source pass).
15. Consequences
What must be proven
- That the procurement structure can credibly deliver the narrow remaining viability conditions (for example, annual ~75% CF or hourly ~90% CF at nominal ~$25/MWh for grey-high edge cases). Not modeled. Not projected. Demonstrated or contractually guaranteed.
- That utilization assumptions survive stress scenarios: curtailment, interconnection delay, weather variance, and matching-period misalignment.
- That capital recovery arithmetic closes at the realized CF, not the nameplate CF or the developer’s base case.
What should be discounted
- Headline electricity prices that do not account for matching constraints, firming costs, transmission losses, or utilization penalties.
- Parity claims built on annual matching assumptions after the transition to hourly matching.
- LCOH projections that treat capacity factor as a fixed input rather than a distribution with downside tail risk.
What should not be assumed
- That cheap power guarantees cheap hydrogen. It does not. Without sufficient utilization for the prevailing delivered-price band, it cannot.
- That the cost curve is smooth. It is not. There are cliffs near 60 percent CF where small utilization losses produce large cost jumps.
- That intermittent strategies are viable without firming. Under hourly matching, they fail the utilization test in most configurations.
For project-specific diligence deliverables, use the professional path below:
For academic correspondence regarding this analysis and assumptions:
Academic contact: jamie@insightquantix.com
Full methodology documentation, sensitivity parameter sets, and benchmark validation protocols are available upon request for academic collaboration or peer review.
This analysis applies the Decision-Grade Parity–Fragility Framework (DG-PFF), developed by Insight Quantix. This note identifies both parity conditions and the fragility thresholds under which those conditions fail.
16. How to Cite This Analytical Note
APA Format
Gomez, J. R. (2026). 45V Utilization Risk: When Cheap Power Breaks Clean Hydrogen Parity (Insight Quantix Analytical Note IQ-AN-H2-2026-02, v1.10). Retrieved from https://insightquantix.com/insights/45v-utilization-risk/
Chicago Format
Gomez, Jamie R. “45V Utilization Risk: When Cheap Power Breaks Clean Hydrogen Parity.” Insight Quantix Analytical Note IQ-AN-H2-2026-02, v1.10, March 2026. https://insightquantix.com/insights/45v-utilization-risk/.
BibTeX
@techreport{Gomez2026_H2_Utilization,
author = {Gomez, Jamie R.},
title = {45V Utilization Risk: When Cheap Power Breaks Clean Hydrogen Parity},
institution = {Insight Quantix},
year = {2026},
type = {Analytical Note},
number = {IQ-AN-H2-2026-02},
month = feb,
url = {https://insightquantix.com/insights/45v-utilization-risk/}
}
17. Changelog
- v1.10 (2026-03-20): Enforced explicit sequential dependency with the parity note (“this analysis begins where parity analysis ends”), shifted dominant-variable framing to utilization-led breakdown (electricity secondary), and made outputs explicit as collapse threshold + fragility gradient.
- v1.9 (2026-03-19): Elevated professional intake to decision-level hierarchy (inside Decision Summary flow), rebalanced bottom inquiry blocks so professional and academic paths have parallel visual weight, and removed subordinate wording that implied professional inquiries were secondary.
- v1.8 (2026-03-19): Reordered the note into explicit two-product flow (decision brief + technical note), moved kill conditions to the top, added a board-ready procurement-strategy x capacity-factor go/no-go matrix, and made WACC underwriting consistency explicit in top-level decision rules.
- v1.5 (2026-03-18): Reordered top narrative flow (problem -> credibility -> intelligence -> framework), added scoped-work CTA and structured intake link, added distinct footer work CTA, fixed section numbering sequence, expanded engagement-delta framing, and added stronger internal cross-links.
- v1.4 (2026-03-18): Added explicit model equation, parameter transparency table, H2A correction explanation, WACC stress quantification, uncertainty envelope, and TEA-LCA linkage clarifications.
- v1.3 (2026-02-22): Normalized encoding artifacts and reconciled decision-regime and appendix assumptions to the corrected H2A 2024.2 parity surface.
- v1.2 (2026-02-22): Refreshed all figures and threshold statements after applying corrected H2A 2024.2 benchmark; updated decision regimes to reflect tightened parity surface.
- v1.1 (2026-02-08): Added literature and policy context update (recent Applied Energy hydrogen studies, 45V final-rule implementation sources, and international market references); refreshed metadata and citation block.
- v1.0 (2026-02-04): Initial release.
18. About the Author
19. About Insight Quantix
Insight Quantix publishes independent analytical work for transparency and decision clarity. The analysis examines benchmark-anchored, audit-defensible economic risk conditions relevant to capital allocation decisions in the $10M-$500M range.
Validation Methodology: ASTM E3200 | ISO 14040/14044 | NREL benchmark-anchored Engine Documentation: Available upon request Website: insightquantix.com
Legal Disclaimer
This analytical note is provided for informational and educational purposes only and does not constitute investment advice, financial advice, engineering design recommendations, or legal interpretation of tax policy. Readers should conduct independent due diligence and consult qualified professionals before making capital allocation decisions.
The analysis reflects representative scenarios based on stated modeling parameters and should not be construed as a guarantee of project performance or economic outcomes. Specific project economics require site-specific analysis accounting for local conditions, technology configurations, and regulatory environments.
Insight Quantix makes no warranties, express or implied, regarding the accuracy, completeness, or reliability of this information for any particular purpose.
© 2026 Insight Quantix. This analytical note may be cited with proper attribution.
